|

		Delays dog 'shovel ready' projects in
		Trump's infrastructure plan


		Send a link to a friend



		 [April 24, 2017]
		By Luciana Lopez

		NEW YORK (Reuters) - U.S. President Donald
		Trump reassured manufacturers gathered in the White House Roosevelt room
		on March 31 that a massive infrastructure program was coming soon.

		“We’re going to make it happen” this year, he said, according to Drew
		Greenblatt, the president of Marlin Steel in Baltimore, who was present.
		“That was actually the first thing that he talked about behind closed
		doors with us,” Greenblatt added.

		But putting a trillion-dollar infrastructure program to work could be
		easier said than done, as some of the projects suggested to the
		administration underscore.

		Project lists submitted by the North America's Building Trades Unions
		and by an outside developer who helped with the transition both contain
		projects that infrastructure builders call “shovel ready.”

		But, for a range of reasons, shovel ready does not always mean ready for
		shovels to break ground. That means any effort to jump-start projects,
		put people to work and inject economic stimulus could drag on Trump’s
		promise for a 10-year, $1 trillion infrastructure project

		After North America's Building Trades Unions (NABTU) president Sean
		McGarvey met with Trump on January 23, the group submitted a total of 26
		bridge, pipeline and water projects. A second list of 51 projects was
		assembled by Ohio developer Dan Slane, who assisted with the transition,
		including everything from inland waterways to ports to a new FBI
		headquarters.




		While details on Trump’s plans are scant, a senior administration
		official said they’re looking for ways to shorten the lengthy permitting
		process.

		“The current system has just lost its way,” he said.

		Nine projects have garnered the support of both Slane and the NABTU,
		appearing on both lists; of those, seven have yet to start construction,
		and one has only done preliminary construction, highlighting how hard it
		is to launch infrastructure projects as quickly as Trump wants to do.

		“The shovel ready moniker that they put on projects, it’s just rarely
		applicable,” said Bill Miller, president and chief executive of two
		companies that overlap the two lists. The Power Company of Wyoming LLC
		is building the Chokecherry and Sierra Madre Wind Energy Project, and
		TransWest Express LLC is developing the TransWest Express Transmission
		Project, crossing Wyoming, Colorado, Utah and Nevada.

		The Chokecherry and Sierra Madre wind project, which is being built in
		part on federal land, took eight years and “tens of millions of dollars”
		before it could recently start construction. The TransWest Express
		transmission project is still waiting for several state-level permits,
		Miller said.

		“To be shovel ready is incredibly expensive and time consuming,” Miller
		added.

		The administration says it wants to get ground broken fast. But some of
		that just might be out of the president’s hands, such as state-level
		permitting.




		“A significant part of the president’s infrastructure plan will focus on
		streamlining regulating and permitting so that it is easier for all
		viable projects to move forward in a timely manner. These reforms might
		not be driven by the hurdles facing a single project, but rather will
		create more certainty in the process overall,” a White House
		spokesperson told Reuters.

		SEAWATER TO DRINKING WATER PLANT HITS THE ROCKS

		 The delays that have beset a desalination plant proposed by Poseidon
		Water, a developer of water-related infrastructure, in Huntington Beach,
		California illustrate how clashing interests and regulations can hold up
		projects.


            [to top of second column]  |

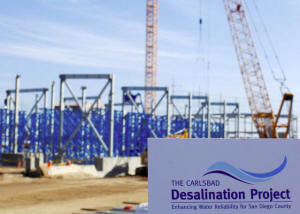

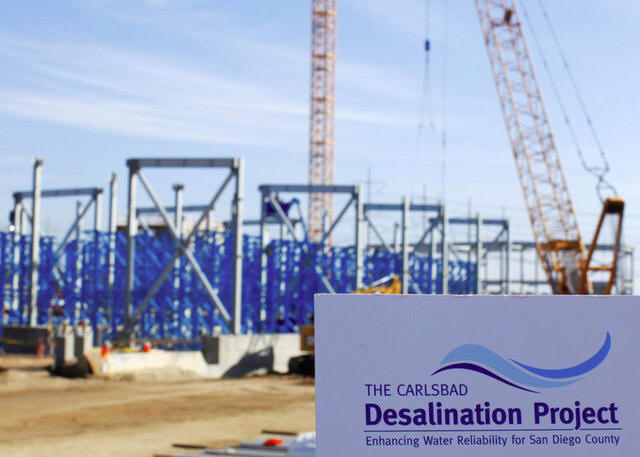

			Construction continues on the Western Hemisphere's largest seawater
			desalination plant in Carlsbad, California January 8, 2014.
			REUTERS/Mike Blake/File Photo

			 Poseidon first proposed the idea of a plant to turn salt water into
			drinking water for Orange County in the late 1990s and started
			permitting in the early 2000s, said Scott Maloni, a vice president
			at Poseidon and the Huntington Beach project manager.

			 The city of Huntington Beach originally approved the project in
			February 2006. But Poseidon still needed to secure 24 permits from
			state agencies, such as approval from the Santa Ana Regional Water
			Quality Control Board for the plant’s national pollutant discharge
			elimination system, which is required by the Environmental
			Protection Agency.

			 After the city issued the necessary local approvals in 2006,
			project builder Poseidon was able to apply to the California Coastal
			Commission.

			 That application was amended several times over the years as the
			project evolved. For example, the plant had to alter its design
			after the state began phasing out power plants that use seawater for
			cooling purposes. Poseidon had planned to desalinate that
			wastewater, and changed its design to instead take in water directly
			from the ocean instead.

			 In 2013, Poseidon shelved the permit application after the state's
			coastal commission directed the company to look into concerns about
			the effects of the operation on fish larva in the area.

			 The application was resubmitted in 2015, and then withdrawn yet
			again in September 2016, because the commission wanted proof the
			plans complied with new, 2015-passed rules from the State Water
			Board on desalination plants.

			 That compelled Poseidon to redesign the plant's seawater intake and
			discharge technologies.

			 The project still needs three more approvals, from the State Lands
			Commission, the Santa Ana Regional Water Quality Control Board and
			the California Coastal Commission.




			 Poseidon says they're confident they’ll secure the last approvals
			soon. But even then, construction might not start until the second
			quarter of 2018, Maloni said.

			 And the objections from environmentalists haven't stopped.

			 The plant is “far from a done deal,” said Mandy Sackett, the
			California policy coordinator for the Surfrider Foundation. The
			foundation argues that the plant is unnecessary, expensive and
			energy-intensive, putting marine life at risk. Sackett said the
			foundation will continue to fight the project.

			 “There’s still several opportunities for public input and important
			regulatory review that is yet to be completed,” she said.

			 (Editing by Joe White and Edward Tobin)
